When Flood Defence Changes Meet Environmental Reality
The landscape of flood risk management in England has evolved dramatically since the devastating floods of 2007, when entire communities found themselves underwater whilst their existing flood defences proved inadequate. Today, when a flood risk activity permit holder needs to modify their operations—whether expanding a flood defence scheme, altering water flow patterns, or changing the scope of existing works—they must navigate the Environment Agency's variation process through Part C8 of the environmental permit application system.

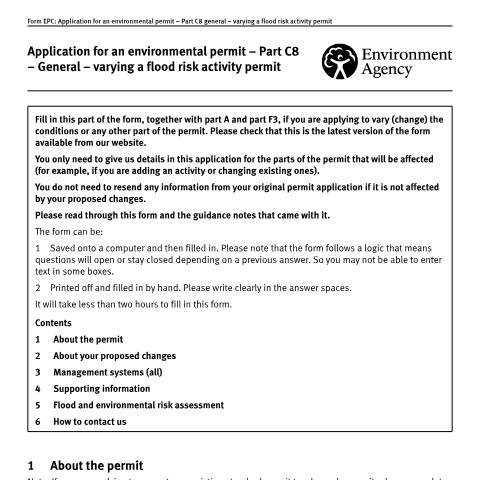

This specialised form serves as the gateway for permit holders who need to vary rather than apply for entirely new permissions. The distinction matters significantly: whilst new applications require comprehensive environmental assessments from scratch, variations focus specifically on proposed changes and their incremental impacts. For operators managing everything from major flood defence schemes to smaller watercourse modifications, understanding when and how to use Part C8 can mean the difference between swift regulatory approval and months of delays.
The Environment Agency's approach reflects a fundamental shift towards risk-proportionate regulation. Rather than treating all modifications equally, the system recognises that changing a maintenance schedule differs vastly from expanding a flood barrier system. This nuanced approach, embedded within the Environmental Permitting (England and Wales) Regulations 2016, requires permit holders to demonstrate not just compliance, but active environmental stewardship.
Navigating the Four Pathways of Permit Variation
The Part C8 form categorises variations into four distinct types, each carrying different regulatory weight and processing timelines. Understanding these categories proves crucial for determining both the complexity of your application and the supporting evidence required.
Administrative Variations: The Straightforward Route
Administrative variations cover changes that don't affect environmental risk—typically updates to contact details, company names, or permit holder information. These modifications usually process within 13 weeks, provided all documentation arrives complete. The Environment Agency treats these as lower priority, but they still require proper notification through Part C8 to maintain legal compliance.
Minor Variations: Small Changes, Significant Documentation
Minor variations encompass changes that may affect the environment but remain within established risk parameters. Examples include modest extensions to existing flood defence structures or alterations to operational hours. Despite the "minor" designation, these applications demand comprehensive risk assessments and typically require 16 weeks for determination.
Other Variations: The Complex Middle Ground
The "other variation" category captures modifications that don't fit neatly into administrative or minor classifications. These might involve changing flood defence materials, altering water discharge points, or modifying maintenance protocols. Processing times extend to approximately 20 weeks, reflecting the need for detailed technical review.
Additional Activity Variations: Expanding Your Scope
When permit holders need to add entirely new activities to existing permits, they enter the most complex variation category. Adding a new flood storage area to an existing scheme, or incorporating additional watercourse management activities, requires comprehensive environmental impact assessment. These applications often take 16 to 20 weeks minimum, depending on the complexity of proposed additions.
| Variation Type | Typical Processing Time | Key Requirements | Risk Assessment Level |
|---|---|---|---|
| Administrative | 13 weeks | Updated details only | None required |
| Minor | 16 weeks | Basic risk assessment | Limited scope |
| Other | 20 weeks | Detailed technical review | Moderate to high |
| Additional Activity | 16-20+ weeks | Full environmental assessment | Comprehensive |
The Document Architecture Behind Successful Applications
Part C8 operates within a broader application framework that demands strategic document preparation. The form explicitly requires completion alongside Part A (general application details) and Part F3 (fee calculation), but the supporting documentation often determines success or failure.
Management System Documentation: Beyond Compliance
Every variation application must demonstrate an effective written management system that identifies and reduces environmental and flooding risks. The Environment Agency doesn't prescribe specific formats, but successful applications typically include risk registers, operational procedures, monitoring protocols, and incident response plans. Certified schemes like ISO 14001 can strengthen applications, though bespoke systems prove equally acceptable when properly documented.
The management system summary required with Part C8 should focus on how proposed changes integrate with existing risk management protocols. Rather than rehashing entire systems, effective summaries highlight specific modifications to procedures, training requirements, or monitoring regimes that variations necessitate.
Site Plans: Precision Matters
Site plans accompanying Part C8 applications must clearly delineate both existing and proposed activities using Ordnance Survey National Grid References. The Environment Agency expects plans to show existing permit boundaries, proposed modification areas, sensitive environmental features, and flood risk zones. Hand-drawn sketches rarely suffice; professional surveyed plans typically prove necessary for anything beyond administrative variations.
Non-Technical Summaries: Bridging Technical and Public Understanding
The required non-technical summary serves dual purposes: demonstrating applicant understanding of proposed changes and providing accessible information for potential public consultation. Effective summaries avoid technical jargon whilst clearly explaining what changes are proposed, why they're necessary, and how environmental risks will be managed.
Risk Assessment: The Environmental Impact Lens
Section 5 of Part C8 addresses flood and environmental risk assessment requirements, but the guidance notes determine when comprehensive assessments become mandatory. The Environment Agency's risk-based approach means that seemingly minor changes can trigger extensive assessment requirements if they affect sensitive locations or protected species.
Flood Risk Considerations
Flood risk assessments must address both direct and indirect impacts of proposed variations. Direct impacts include changes to water flow patterns, flood storage capacity, or defence effectiveness. Indirect impacts might involve altered maintenance access affecting long-term flood defence integrity, or construction activities temporarily increasing flood risk.
The assessment must consider climate change projections, with the Environment Agency expecting applicants to demonstrate resilience to increased flood frequencies and intensities. This forward-looking approach reflects the 2021 National Flood and Coastal Erosion Risk Management Strategy's emphasis on adaptive management.
Environmental Impact Evaluation
Environmental risk assessments extend beyond flood considerations to encompass biodiversity, water quality, air emissions, and noise impacts. The Environment Agency's guidance emphasises cumulative effects—how proposed variations combine with existing activities and other developments in the area.
For variations affecting or near Sites of Special Scientific Interest (SSSIs), Special Areas of Conservation (SACs), or Special Protection Areas (SPAs), the assessment requirements intensify significantly. Natural England consultation often becomes necessary, extending determination timelines and requiring additional specialist input.
Permit Consolidation: Streamlining Multiple Permissions
Section 2c of Part C8 addresses permit consolidation—combining multiple existing permits into a single permission. This option appeals particularly to operators managing complex flood defence schemes that have accumulated multiple permits over time through phased development or acquisitions.
The Environment Agency strongly recommends pre-application discussions for consolidation applications, recognising the technical complexity involved. Successful consolidations require demonstrating that combined operations won't increase overall environmental risk and that management systems can effectively oversee the enlarged scope.
Strategic Considerations for Consolidation
Permit consolidation offers operational benefits through simplified reporting, unified monitoring requirements, and streamlined variation processes for future changes. However, consolidation also means that enforcement action affecting one activity can potentially impact the entire consolidated permit.
The fee structure for consolidation applications reflects this complexity, with charges based on the most complex activity within the consolidated permit. This can result in higher ongoing charges for previously lower-risk activities, requiring careful cost-benefit analysis before proceeding.
Pre-Application Engagement: Reducing Uncertainty
Section 1a of Part C8 specifically requests details of pre-application discussions, reflecting the Environment Agency's emphasis on early engagement. These discussions, whilst not mandatory, can significantly improve application success rates and reduce determination times.
The Value of Early Consultation
Pre-application meetings allow permit holders to test the regulatory acceptability of proposed changes before investing in detailed design work or risk assessments. The Environment Agency's area teams can provide site-specific guidance on likely concerns, required assessment scope, and potential alternative approaches.
For complex variations, particularly those involving additional activities or environmental sensitivities, pre-application advice often proves invaluable. The service operates on a cost-recovery basis, but fees typically represent a fraction of the costs associated with poorly prepared applications or subsequent appeals.
Documentation and Follow-Through
When referencing pre-application discussions in Part C8, provide specific details including meeting dates, attendees, and key advice received. This information helps case officers understand the application context and ensures consistency between pre-application guidance and formal determination.
The permit reference number or discussion details requested in section 1a should be comprehensive enough to allow Environment Agency staff to locate relevant file records quickly. Incomplete references can delay application processing whilst officers attempt to trace previous correspondence.
Operational Realities: From Submission to Determination
The Part C8 form represents just the beginning of the variation process. Understanding what happens after submission—and how to respond effectively to Environment Agency queries—often determines whether applications proceed smoothly or encounter significant delays.
The Duly Made Assessment
Upon receiving a Part C8 application, the Environment Agency conducts a "duly made" assessment to verify completeness. This initial review checks for required forms, fees, and supporting documents. Applications failing this assessment are rejected, requiring resubmission with additional delay.
The two-hour completion time estimate provided in the form guidance applies only to basic form completion, not supporting document preparation. Realistic project planning should allow weeks or months for comprehensive risk assessments, site surveys, and technical drawings.
Consultation and Determination
Depending on variation type and potential impacts, the Environment Agency may undertake public consultation, consult statutory bodies like Natural England or Historic England, or seek technical specialist input. Applicants receive notification of consultation periods and can respond to concerns raised.
The determination process concludes with permit variation, refusal, or requests for additional information. Varied permits typically include updated conditions reflecting approved changes, whilst refusals must provide clear reasons and appeal rights information.
Post-Variation Responsibilities
Successful Part C8 applications result in varied permits that may include new conditions, monitoring requirements, or reporting obligations. Permit holders must ensure operational procedures reflect these changes and that staff receive appropriate training on modified requirements.
The Environment Agency's compliance monitoring continues throughout the varied permit's lifetime, with inspection frequencies often increasing following significant variations. Maintaining detailed records of variation implementation helps demonstrate ongoing compliance and supports future variation applications.
Risk Assessment Requirements and Technical Documentation
When varying a flood risk activity permit through Part C8, the Environment Agency requires comprehensive risk assessment documentation that demonstrates how your proposed changes will affect flood risk management. This technical evaluation forms the backbone of your application and must address both immediate and long-term flood risk implications.
Your flood risk assessment must include detailed hydraulic modelling where your variation involves changes to water flow patterns, channel capacity, or flood storage areas. The Environment Agency typically expects modelling to cover a range of return periods, including 1 in 20, 1 in 100, and 1 in 1000 year flood events, with climate change allowances factored into future scenarios. For coastal locations, you'll need to incorporate sea level rise projections and tidal surge considerations.
The assessment should clearly identify all receptors that could be affected by your proposed variation, including residential and commercial properties, critical infrastructure such as hospitals and schools, agricultural land, and designated environmental sites. You must quantify potential flood risk changes using appropriate metrics such as flood depth, velocity, and duration, presenting this information in both tabular format and through detailed flood extent mapping.
Environmental impact considerations require particular attention when your variation affects Sites of Special Scientific Interest (SSSIs), Special Areas of Conservation (SACs), or other protected habitats. The Environment Agency will scrutinise how your proposed changes might alter natural flood processes that support ecological functions, including spawning grounds for fish, wetland hydrology, and sediment transport patterns that maintain habitat diversity.
Technical drawings and survey information must meet Environment Agency standards for accuracy and presentation. Topographical surveys should be conducted to an appropriate level of precision, typically requiring accuracy within ±50mm for critical flood defence structures. Cross-sectional surveys of watercourses must extend sufficiently upstream and downstream to capture the full hydraulic influence of your proposed works, often requiring survey coverage extending several hundred metres beyond the immediate work area.
Where your variation involves temporary works during construction phases, you'll need to demonstrate how flood risk will be managed throughout the construction period. This includes contingency planning for flood events during construction, temporary flood protection measures, and protocols for rapid demobilisation of plant and materials should flood warnings be issued.
Consultation Requirements and Stakeholder Engagement
The Part C8 variation process includes mandatory consultation periods that vary depending on the nature and scale of your proposed changes. Understanding these consultation requirements early in your planning process helps ensure adequate time allocation and proper stakeholder engagement.
For variations classified as substantial changes, the Environment Agency conducts a 20 working day public consultation period. This applies when your proposed modification could significantly alter flood risk to third parties, affect navigation rights, or impact environmental designations. During this period, your application details are published on the Environment Agency's public register, and interested parties can submit representations that the Agency must consider before reaching a decision.
Internal consultee requirements depend on your location and the nature of proposed changes. Natural England consultation is mandatory where your variation affects or is located within 2km of a European protected site, SSSI, or National Nature Reserve. Historic England becomes a statutory consultee when works are proposed within 500m of scheduled monuments or listed buildings, while the Marine Management Organisation must be consulted for coastal flood risk activities below the mean high water mark.
Local authority consultation serves multiple purposes, as councils hold responsibilities for local flood risk management under the Flood and Water Management Act 2010. Your local Lead Local Flood Authority (LLFA) will review how your proposed variation aligns with their Local Flood Risk Management Strategy and may provide valuable insights into local flood history and community concerns.
Navigation authorities require consultation where your variation could affect navigation rights or commercial waterway operations. This includes British Waterways (Canal & River Trust) for canal systems, Port Authorities for tidal waters, and the Environment Agency's own navigation teams where they hold navigation responsibilities. These consultations often reveal operational constraints that could affect your variation design or implementation timing.
Proactive engagement with affected landowners and local communities, while not legally mandated, significantly improves application success rates. Early dialogue helps identify potential objections, allows design modifications to address legitimate concerns, and demonstrates your commitment to responsible flood risk management. Community liaison is particularly valuable in rural areas where local knowledge of historical flooding patterns and land use practices can inform your risk assessment.
Parish councils and community groups often provide detailed local flood intelligence that may not be captured in Environment Agency flood maps. Their input can highlight vulnerable properties, access routes critical during flood events, and seasonal variations in flood risk that could influence your variation design or operational protocols.
Compliance Monitoring and Post-Variation Obligations
Once your Part C8 variation is approved, ongoing compliance monitoring becomes a legal obligation that extends throughout the lifetime of your modified permit. The Environment Agency's compliance framework includes both self-monitoring requirements and regulatory inspection protocols that ensure your varied activities continue to meet flood risk management objectives.
Self-monitoring obligations typically include regular inspections of flood risk management infrastructure, with inspection frequencies varying according to asset criticality and flood season timing. High-risk structures such as flood barriers and pumping stations may require weekly inspections during winter months, while lower-risk features might need monthly or quarterly checks. Your monitoring regime must be documented in a formal inspection and maintenance plan submitted as part of your variation application.
Environmental monitoring requirements focus on ecological impacts where your variation affects sensitive habitats or protected species. This might include water quality monitoring upstream and downstream of your works, fish population surveys where spawning areas are affected, or vegetation monitoring in adjacent wetland areas. Monitoring protocols must follow Environment Agency technical guidance, with specific sampling methodologies, frequency requirements, and reporting formats clearly defined in your permit conditions.
Flood event reporting obligations require you to notify the Environment Agency of any flood incidents affecting your permitted activities within 24 hours of occurrence. This notification triggers a formal incident investigation process, requiring detailed reporting on flood depths, durations, property impacts, and any emergency response actions taken. The Environment Agency uses this intelligence to refine flood risk models and may require additional risk reduction measures if patterns of concern emerge.
Annual compliance reports provide comprehensive performance summaries covering all aspects of your varied permit conditions. These reports must demonstrate compliance with flood risk management objectives, environmental protection measures, and any community liaison commitments made during the application process. The Environment Agency reviews these reports as part of their regulatory oversight function and may initiate enforcement action where non-compliance is identified.
Adaptive management provisions allow permit conditions to be modified in response to changing circumstances such as climate change impacts, new flood risk intelligence, or changes in local vulnerability. The Environment Agency may require you to implement additional risk reduction measures where monitoring data suggests your original risk assessment was optimistic, or conversely, may agree to condition relaxations where performance demonstrates lower risk than anticipated.
Record keeping requirements extend beyond basic compliance monitoring to include detailed documentation of all maintenance activities, emergency response actions, stakeholder communications, and any temporary modifications made under emergency provisions. These records must be retained for the lifetime of your permit and made available for Environment Agency inspection with reasonable notice. Digital record keeping systems are increasingly expected, with requirements for backup and data security measures that comply with UK GDPR provisions for environmental data management.
